FUNDED PROJECTS

November 2022

  • New 120ft Air Traffic Control Tower to replace the 64ft Tower
    • Location Siting - November 2022
    • Design of 120ft Tower - 2023
    • Construction - 2024
    • Completion - 2025

April 2022

  • Replacement of Antiquated Airport Generator with Larger Capacity Generator
    • Schedule for Completion - April 2022
    • COMPLETED APRIL 2022
  • Replacement of Hangar 755 Roof
    • Out for Bids - March 2022
    • Construction - June 2022
    • Schedule for Completion - September 2022
    • COMPLETED SEPTEMBER 2022

November 2021

  • Repair Pilot Control Lighting System Multiple Level Light Intensity
    • Installation - November 2021
    • Schedule for Completion - Mid-December 2021
    • COMPLETED MARCH 2022

October 2021

  • Demolition of Hangar N-850
    • Out for Bids - October 2021
    • Demolition - Mid-January 2022
    • Scheduled for Completion - March 2022
    • COMPLETED MARCH 2022

September 2021

  • Design of $2 Million Expansion of Airport Terminal
    • Design - September 2021 - February 2022
    • Out for RFQ for Construction Manager General Contractor - April 2022
    • Construction - June 2022
    • Schedule for Completion - October 2024
      Terminal Expansion CMGC RFP Appendix A_Page_1 Opens in new window
      Terminal_Front Opens in new window
      Terminal_interior_1 Opens in new windowTerminal_interior_2 Opens in new window

August 2021

  • Remodel of Restaurant in Terminal
    • Design - Completed August 2021
    • Out for Bids - September 2021
    • Construction - October 2021
    • Schedule for Completion - March 2021
    • COMPLETED APRIL 2022

July 2021

  • Demolition of Old Tower on Top of Terminal Building.
    • COMPLETED AUGUST 2021
    • Time Lapse Video of Removal of Old Air Traffic Tower - Click Here

June 2021

  • Demolition of Hangars N-420, S-543, S-553.
    • COMPLETED JUNE 2021
  • Construction of Fiber Optic Network Loop Around OGD Airport for Internet Access / Data Transmission.
    • Out for Bids - June 2021
    • Construction Started - August 2021
    • Scheduled for Completion - January 2022
    •  COMPLETED DECEMBER 2021
  • Maintenance Complex & West Side of Airport Improvements - Grading / Cleanup; Utilities Upgrade; Creation of West Side Entrance.
    • Under Design - June 2021 - January 2022 See Diagram below
    • Out for Bids - February 2022
    • Construction Start - May 2022
    • Schedule for Completion - December 2022
  • Construction of New Partial Parallel Taxiway Foxtrot, West of Approach End of Runway 17.
    • Design - December 2021 See Diagram below
    • Out for Bids - March 2022
    • Construction - May 2022
    • Schedule for Completion - December 2022

      Google_WestSide Opens in new windowWest Side Before
      New_Taxiway_West_Hangar Opens in new window
      New Taxiway F &
      West Side Ramp Access
      Westside2 Opens in new windowWest Side
      Before & After
      West Exhibit Opens in new windowWest Side Ramp

June - Sept 2021

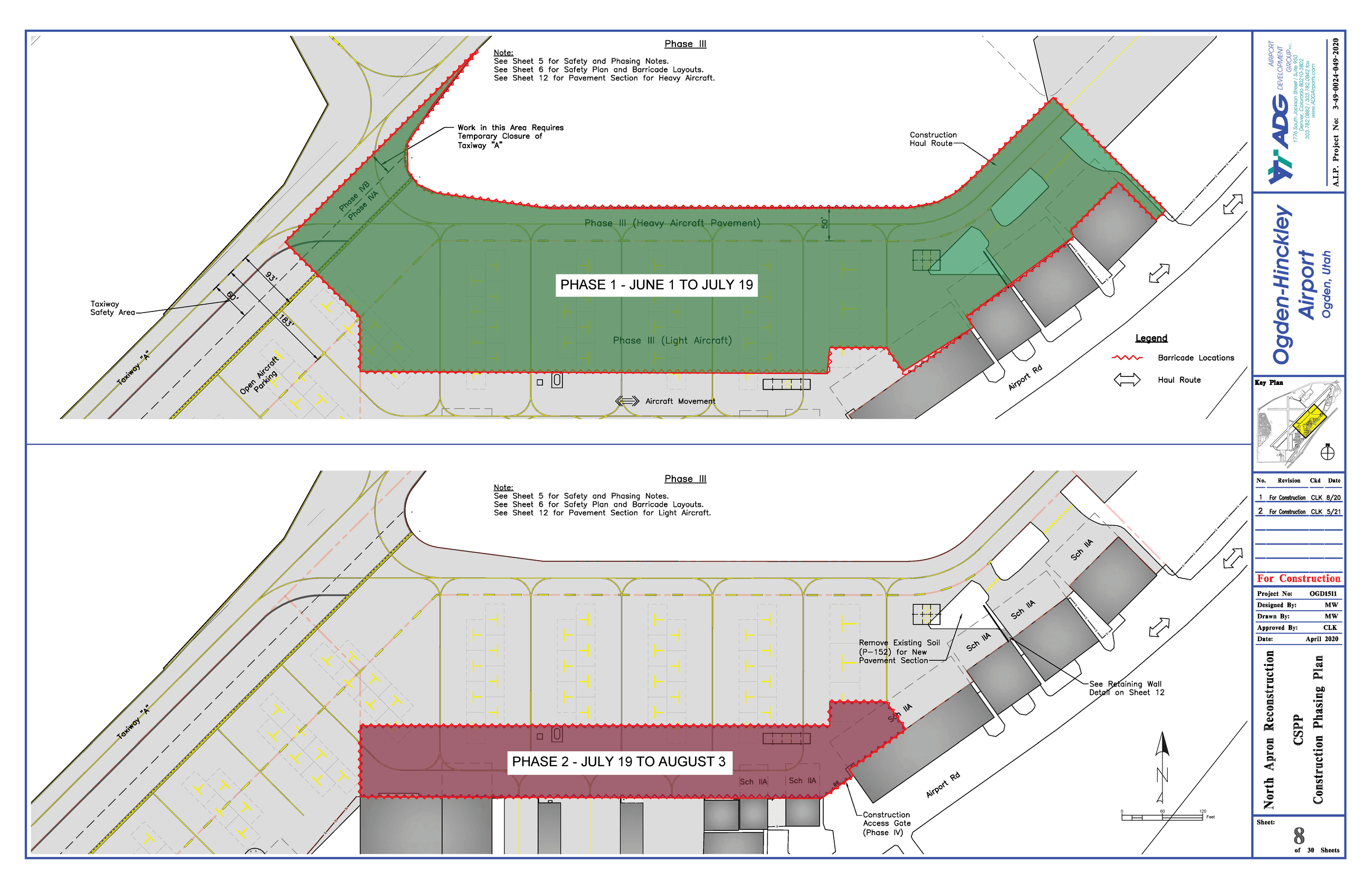

OGD AIRPORT NORTH TIE-DOWN APRON RECONSTRUCTION, SCHEDULE II - COMPLETED DECEMBER 2021

Granite Construction is scheduled to begin the second half of the North Tie-Down Apron Reconstruction on Tuesday June 1st, 2021.

Phase One - June 1st - July 19th

The pavement will be removed airside of four hangars. Each of these hangar owners & users should make arrangements to not have aircraft access in or out of their hangars between June 1st and July 19th.

Affected Hangars - N-1302, the northmost bay only, Hangar N-1410, Hangar N-1460, and Hangar N-1504.

Phase Two - July 19th - August 3rd

Twenty one (21) hangars will lose the ability to get an aircraft from their hangar to the Runway & Taxiways. Each hangar owner or user will need to make arrangements to not have aircraft access in or out of their hangars between July 19th and August 23rd.

Affected Hangars - Hangar N848, Hangar N-824, Hangars N-946, N-942, N-936, N-930, N-924, N-918, N-1038, N-1034, N-1028, N-1022, N-1016 & N-1010, Hangar N-916, Hangar N-1004, Hangar 1108, Hangar N-1116, Hangar N-1110, Hangar N-1204, and Hangar N-1302.

Additional time will be required to core the tie-down anchor points and to paint in the striping and the tie-down "T's".

These dates represent the best estimates for each phase, but the actual times could vary somewhat.

OGD North Apron Phasing Plan May 2021 (1) Opens in new window

Other Misc. Projects

  • Utah 99's Painting of Compass Rose
    • Outlining and Painting of 80 ft Compass Rose - Sept 2022 (tentatively due to difficulty acquiring paint.)
